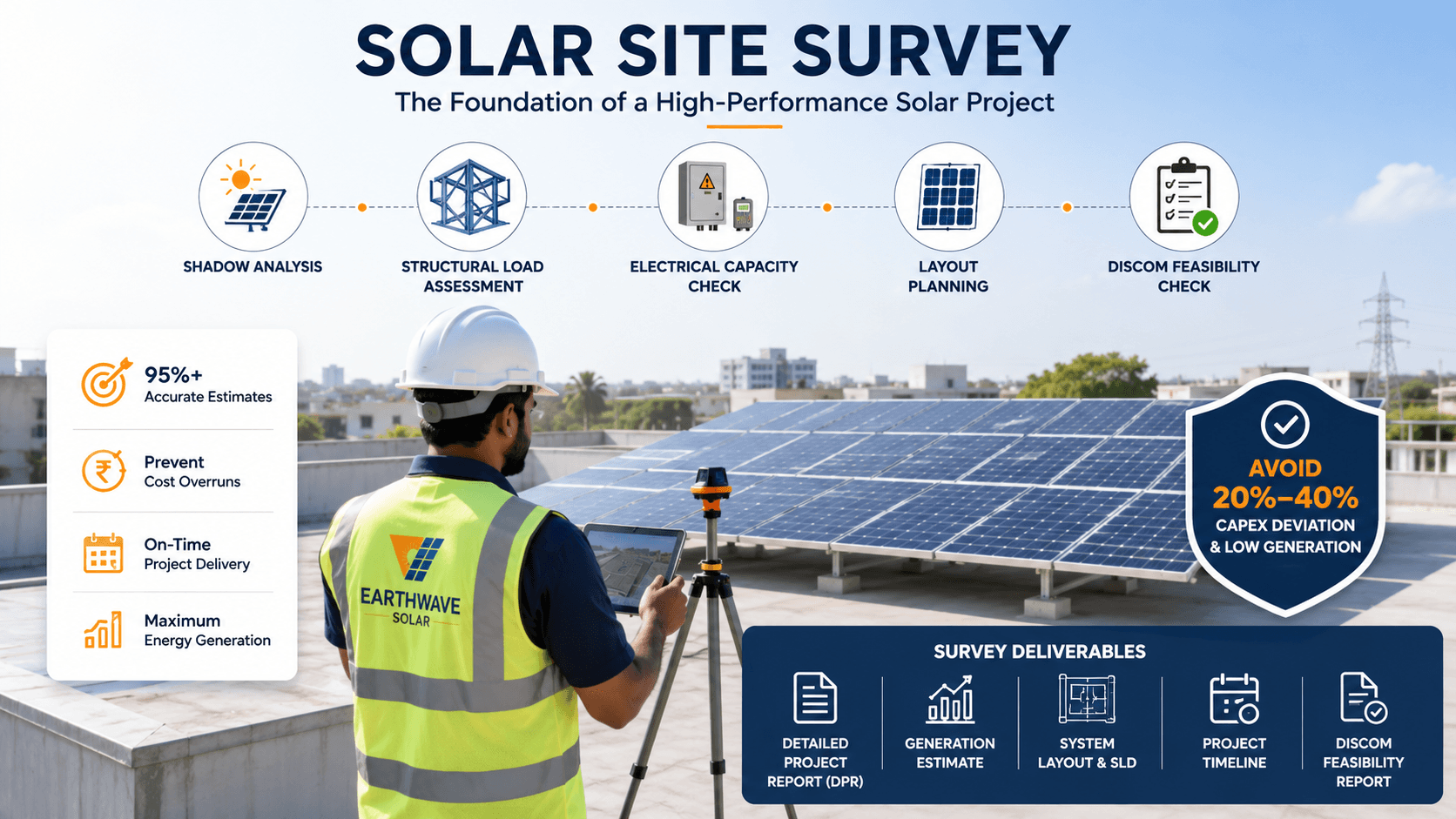

Solar Site Survey

How a Solar Site Survey Works Before EPC Begins

2026-06-12T00:00:00.000Z9
How a Solar Site Survey Works Before EPC Begins

A solar site survey is the on-ground engineering audit your EPC partner runs before any contract, design, or panel order, to verify shadow patterns, structural strength, electrical capacity, and generation potential of your site.

image - 2026-07-02T211022.115

Done right, it locks your CAPEX, generation estimate, and timeline with 95%+ accuracy and prevents the cost overruns that kill 1 in 3 poorly-planned solar projects.

If you are new to the broader workflow, start with our guide on the solar EPC process in Gujarat before reading this article.


TL;DR: Pre-EPC Solar Site Survey in 5 Bullets

  • A solar site survey is a physical, engineering-grade audit of your roof or land before the EPC contract is signed.

  • It covers shadow analysis, structural load, electrical infrastructure, layout planning, and DISCOM feasibility.

  • A proper survey takes 1 to 5 days and produces a Detailed Project Report (DPR) plus a generation estimate.

  • Skipping or shortcutting the survey causes 20% to 40% CAPEX deviations, low generation, and DISCOM delays.

  • A serious EPC like

    Earthwave Solar

    bundles this audit into Step 2 of its process before any quotation is locked.

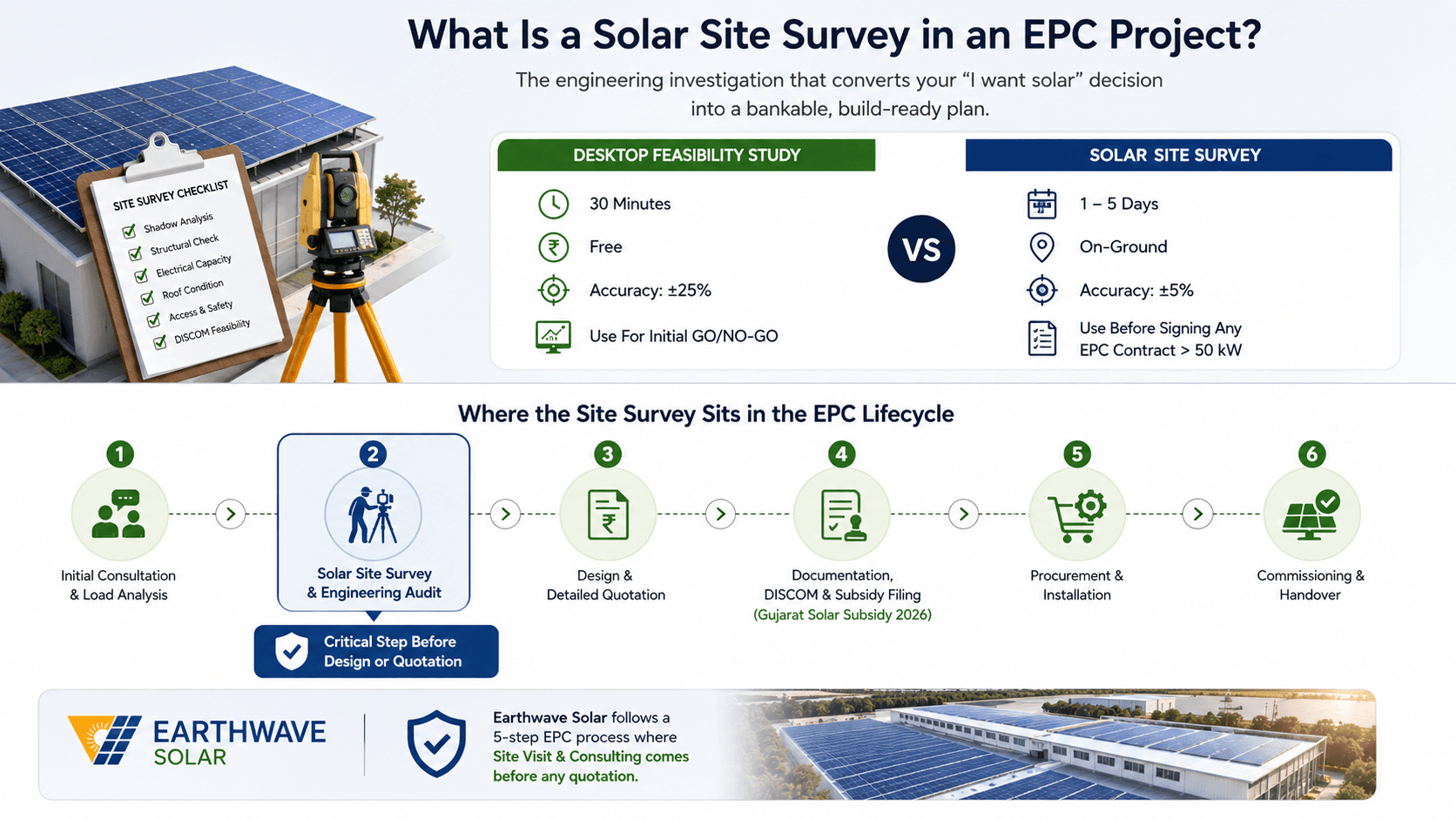

What Is a Solar Site Survey in an EPC Project?

image - 2026-07-02T211025.538

A solar site survey is the engineering investigation that converts your "I want solar" decision into a bankable, build-ready plan. It is the bridge between intent and execution in the EPC workflow.

Solar Site Survey vs. Desktop Feasibility Study

A site survey is physical and project-grade. A desktop feasibility study is a quick screening done on Google Earth and satellite irradiance data.

  • Desktop feasibility study:

    30 minutes, free, accuracy of plus or minus 25%.

  • Solar site survey:

    1 to 5 days, on-ground, accuracy of plus or minus 5%.

  • Use case:

    Use desktop for initial GO/NO-GO. Use the site survey before signing any EPC contract above 50 kW.

Where the Site Survey Sits in the EPC Lifecycle

The site survey is Step 2 in a clean EPC workflow, right after the initial consultation and before design, quotation, or BOM.

  1. Initial consultation and load analysis

  2. Solar site survey and engineering audit

  3. Design and detailed quotation

  4. Documentation, DISCOM, and subsidy filing (see

    Gujarat solar subsidy 2026)

  5. Procurement and installation

  6. Commissioning and handover

This is exactly how Earthwave Solar structures its 5-step process, with Site Visit & Consulting placed before any quotation goes out.

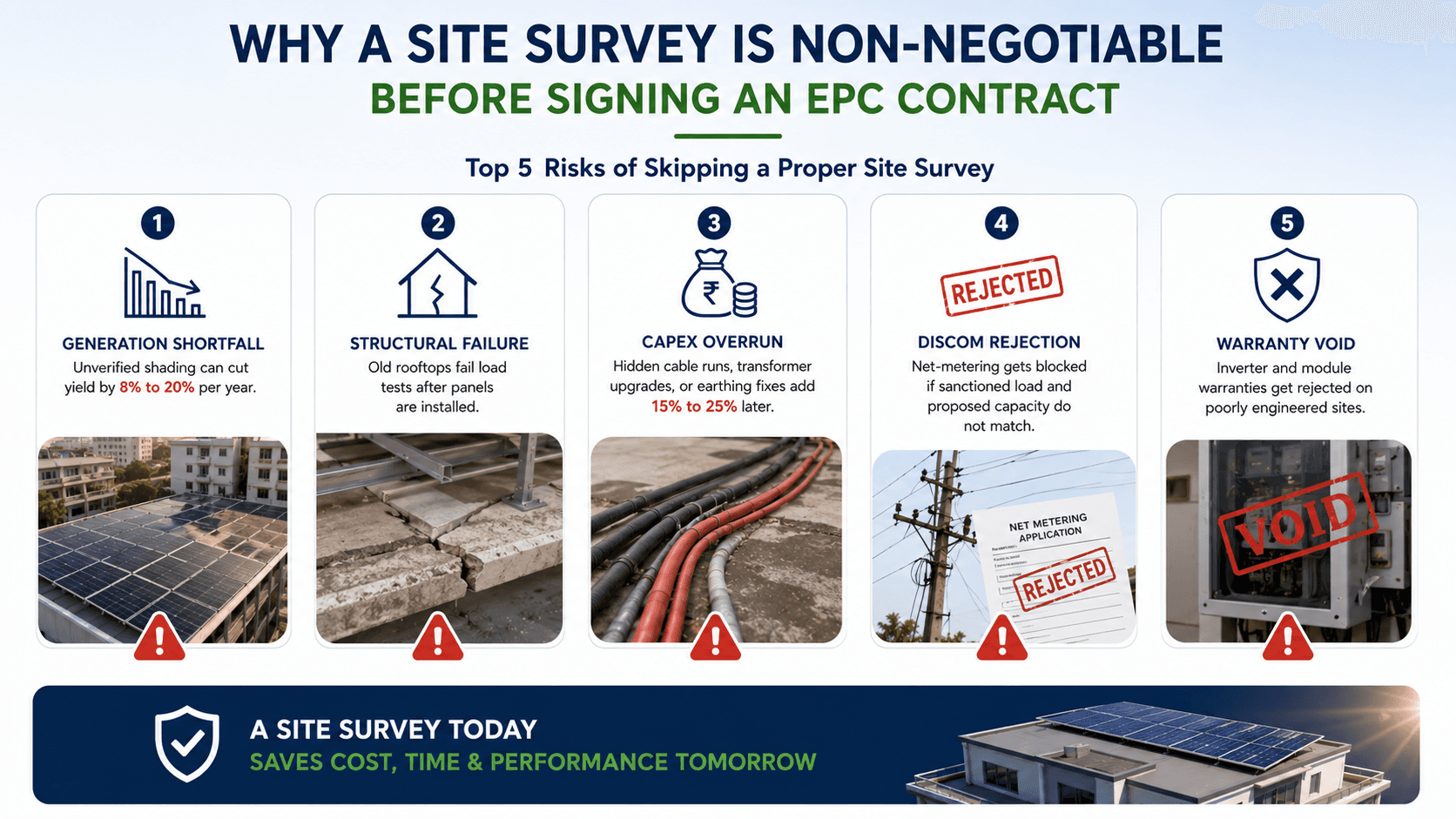

Why a Site Survey Is Non-Negotiable Before Signing an EPC Contract

image - 2026-07-02T211030.271

Skipping the pre-EPC site survey is the single biggest reason solar projects under-perform or blow their budget. The survey is your only objective evidence that the proposal in front of you is real. For a deeper buyer-protection lens, read our breakdown of solar EPC red flags in Gujarat.

Top 5 Risks of Skipping a Proper Site Survey

  • Generation shortfall:

    Unverified shading can cut yield by 8% to 20% per year.

  • Structural failure:

    Old rooftops fail load tests after panels are installed.

  • CAPEX overrun:

    Hidden cable runs, transformer upgrades, or earthing fixes add 15% to 25% later. See our

    solar EPC cost guide for Gujarat factories

    .

  • DISCOM rejection:

    Net-metering

    gets blocked if sanctioned load and proposed capacity do not match.

  • Warranty void:

    Inverter and module warranties get rejected on poorly engineered sites.

How a Site Survey Impacts Your Final CAPEX and ROI

A precise survey tightens your CAPEX band from "plus or minus 25%" to "plus or minus 5%". For a 500 kW plant at roughly ₹3.5 Cr, that single audit protects ₹50 to ₹70 lakhs of investment risk and locks a 5 to 7 year payback.

Real-World Example

A 170 kW textile rooftop project at Pari Textile, Diamond Nagar required a proper pre-installation audit because of mixed roof zones. A skipped survey would have placed 20% of the modules in shadow zones during winter mornings. The on-site shadow analysis re-routed those strings and protected nearly ₹4 lakhs of annual generation revenue. For more textile sector insights, read solar for textile units in Surat.

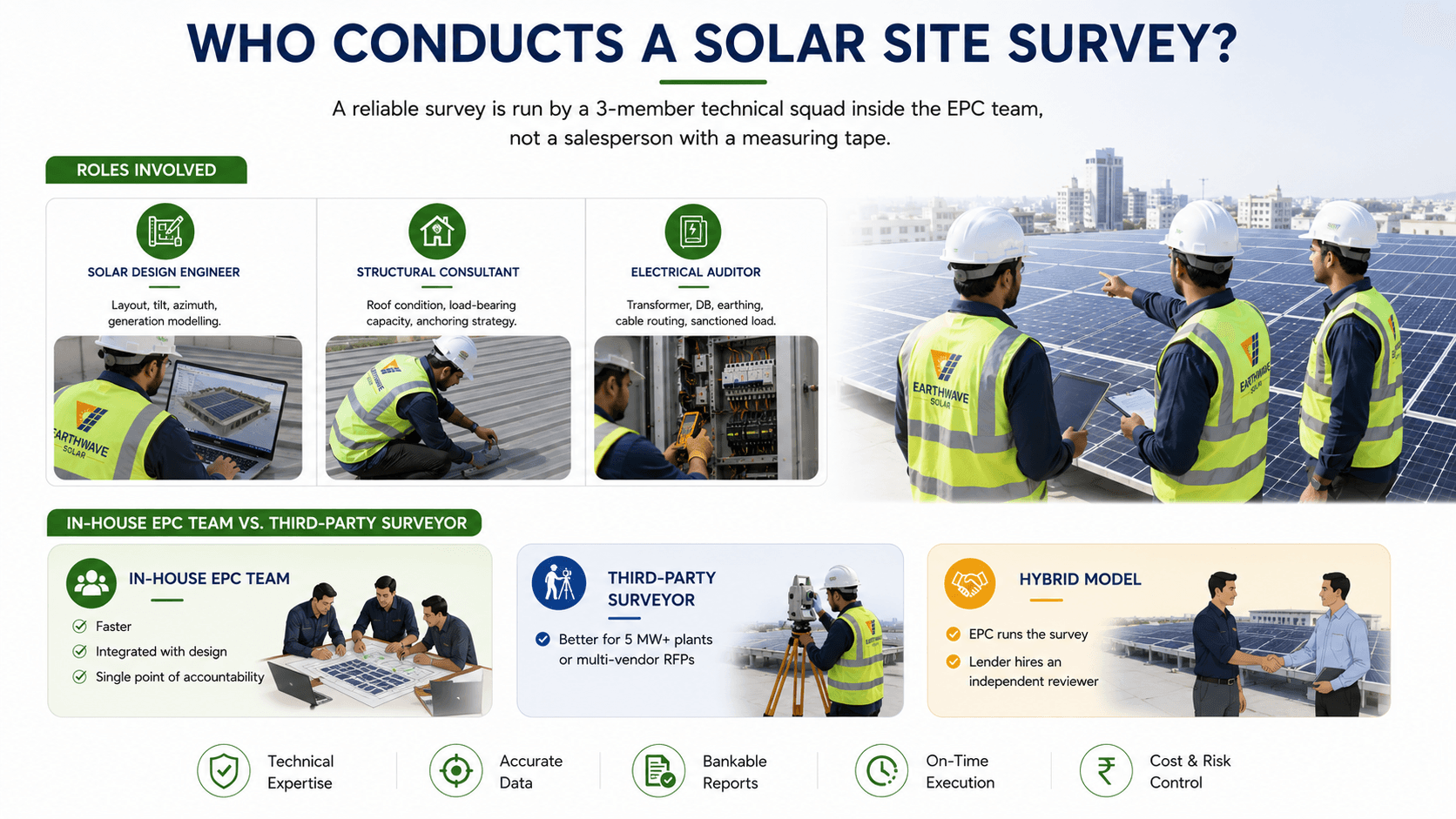

Who Conducts a Solar Site Survey?

image - 2026-07-02T211033.916

A reliable solar site survey is run by a 3-member technical squad inside the EPC team, not a salesperson with a measuring tape. Meet our engineering and leadership team to see how this works in practice.

Roles Involved

  • Solar design engineer:

    Layout, tilt, azimuth, generation modelling.

  • Structural consultant:

    Roof condition, load-bearing capacity, anchoring strategy.

  • Electrical auditor:

    Transformer, DB, earthing, cable routing, sanctioned load.

In-House EPC Team vs. Third-Party Surveyor

Choose an in-house EPC survey team for accountability, third-party only for very large or sensitive sites. Use our solar EPC company checklist to vet either option.

  • In-house EPC team:

    Faster, integrated with design, single point of accountability.

  • Third-party surveyor:

    Better for 5 MW plus plants or multi-vendor RFPs.

  • Hybrid model:

    EPC runs the survey, lender hires an independent reviewer.

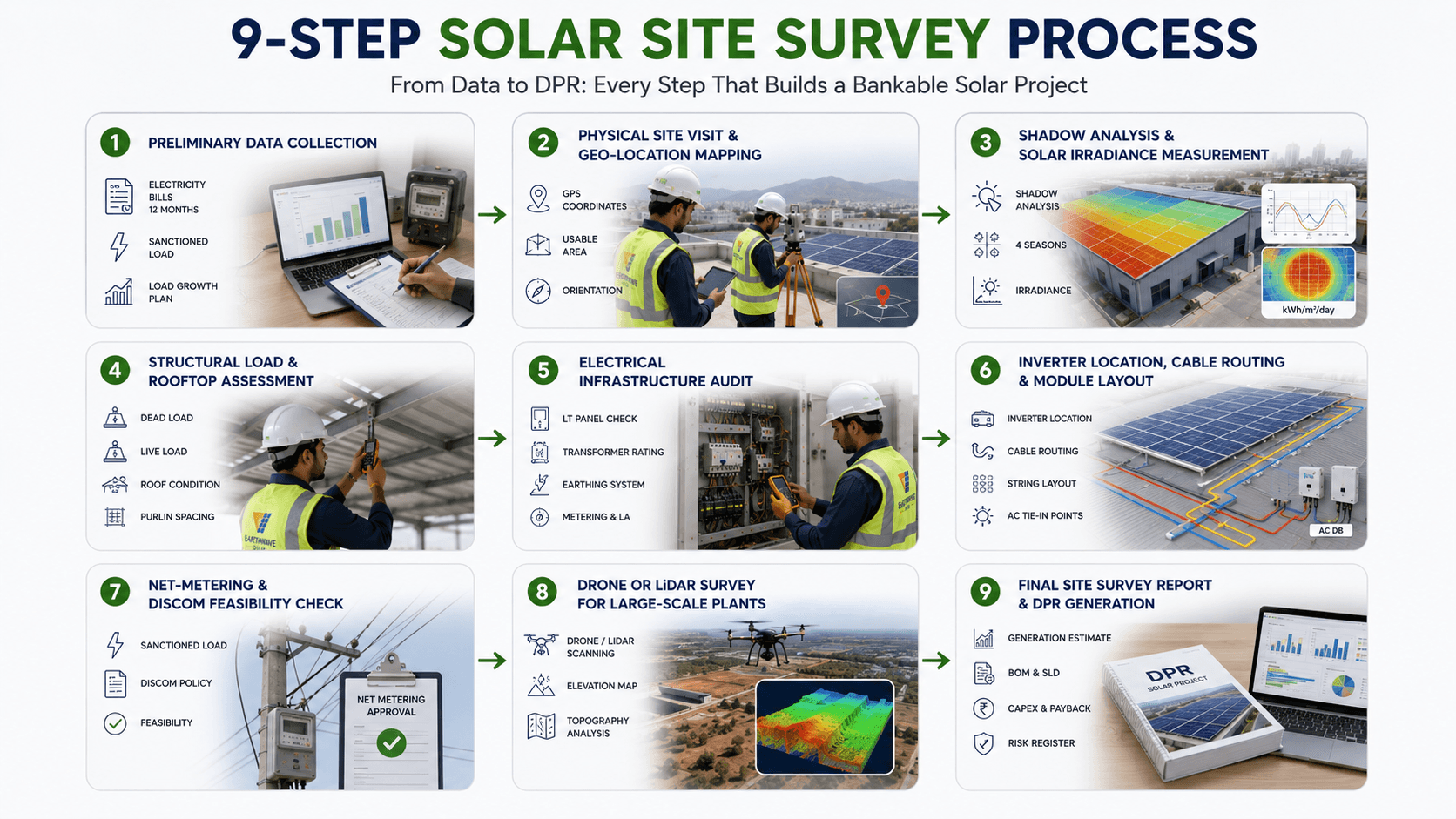

Step-by-Step Process of a Solar Site Survey Before EPC Begins

image - 2026-07-02T211037.234

A professional pre-EPC solar site survey follows a fixed 9-step process. Each step produces a specific data point that feeds the final DPR.

Step 1: Preliminary Data Collection

The survey starts with documents, not a site visit. The EPC collects 12 months of electricity bills, sanctioned load, contract demand, and the load growth plan.

Step 2: Physical Site Visit and Geo-Location Mapping

Engineers visit the site, capture GPS coordinates, measure usable area, and confirm orientation. For ground-mount projects like Earthwave Solar's 80 MW Mota Mandvada plant, drone-based geo-mapping replaces manual measurement. See more in our ground-mounted solar plant India guide.

Step 3: Shadow Analysis and Solar Irradiance Measurement

Engineers run shadow simulations across all 4 seasons using solar pathfinder readings and PVsyst or Helioscope models. The output is a year-round shading map and a site-specific irradiance value, not a city average. For cloudy region readers, also see do solar panels work on cloudy days in India.

Step 4: Structural Load and Rooftop Condition Assessment

A structural engineer checks dead load, live load, beam spacing, and roof age. Industrial sheet roofs are tested for purlin spacing. RCC roofs are checked for waterproofing and core strength. Pair this with our guide on choosing the right solar mounting structure and the land and civil engineering checklist for ground-mounted projects in Gujarat.

Step 5: Electrical Infrastructure Audit

The electrical auditor inspects the LT panel, transformer rating, earthing pits, lightning arrestor, and metering. The goal is to confirm the grid can absorb the proposed kW without upgrades, or to budget the upgrade upfront.

Step 6: Inverter Location, Cable Routing, and Module Layout

The team finalises inverter rooms, DC cable lengths, AC tie-in points, and string layout. Cable losses above 2% are flagged and re-routed at this stage, not after installation. Refer to our solar inverter guide for India and how to integrate Wave on-grid inverters.

Step 7: Net-Metering and DISCOM Feasibility Check

The EPC verifies whether your sanctioned load supports the proposed kW under your state DISCOM policy. For Gujarat readers, see Gujarat rooftop solar policy 2026 and net-metering solar income in Gujarat.

Step 8: Drone or LiDAR Survey for Large-Scale Plants

For ground-mount or rooftop sites above 500 kW, drone and LiDAR scans produce centimetre-accurate elevation maps. This avoids costly civil rework on uneven terrain. See pricing context in ground-mounted solar plant cost in India.

Step 9: Final Site Survey Report and DPR Generation

The audit closes with a Detailed Project Report covering generation estimate, BOM, SLD, CAPEX, payback, and risk register. This DPR is what the CFO signs off on, not the brochure. Cross-check the numbers using our solar installation cost in India benchmarks.


Tools and Equipment Used in a Professional Solar Site Survey

image - 2026-07-02T211042.033

A credible pre-EPC solar feasibility assessment uses calibrated instruments, not eyeballing. The equipment list reveals whether your EPC is serious or shortcutting.

Measurement and Modelling Tools

  • Pyranometer:

    Measures direct irradiance in W per sq.m.

  • Solar pathfinder:

    Maps sun path and shadow obstructions.

  • Anemometer:

    Captures wind speed for structural load calculation.

  • Lux meter and IR thermometer:

    Surface temperature and reflectivity checks.

Software and Drone Stack

  • PVsyst and Helioscope:

    Generation modelling and shading loss analysis.

  • AutoCAD and SketchUp:

    Layout and 3D modelling.

  • DJI drones with LiDAR payloads:

    Land contour and obstacle mapping.

Post-commissioning, this data plugs into a solar SCADA monitoring system for live performance tracking.

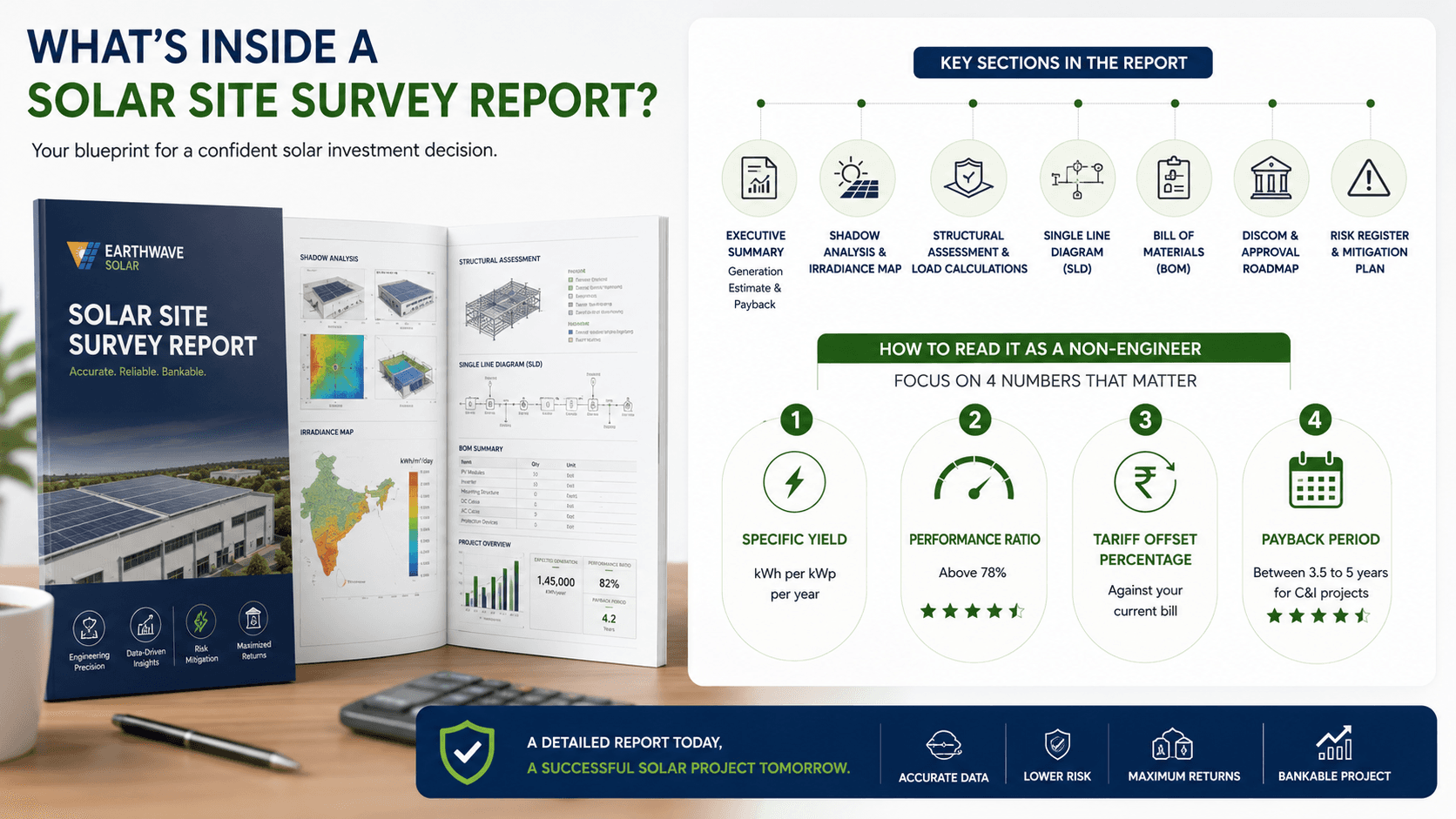

What's Inside a Solar Site Survey Report?

image - 2026-07-02T211044.695

A complete solar site survey report runs 25 to 60 pages and gives you everything needed to sign or reject the EPC contract with confidence. For technical depth, refer to our datasheets library.

Key Sections in the Report

  • Executive summary with generation estimate and payback

  • Shadow analysis and irradiance map

  • Structural assessment and load calculations

  • Single Line Diagram (SLD)

  • Bill of Materials (BOM)

  • DISCOM and approval roadmap

  • Risk register and mitigation plan

How to Read It as a Non-Engineer

Focus on 4 numbers as a CFO or facility head:

  1. Specific yield

    in kWh per kWp per year

  2. Performance Ratio (PR)

    above 78%

  3. Tariff offset percentage

    against your current bill (see commercial solar electricity cost savings)

  4. Payback period

    between 3.5 and 5 years for C&I, factoring in

    accelerated depreciation tax benefits


How Long Does a Solar Site Survey Take and What Does It Cost?

A pre-EPC solar site survey takes 1 to 5 days on site and 5 to 10 working days for the final report. Most reputable EPCs absorb the cost when the contract is signed.

Typical Timelines

  • Residential rooftop (up to 30 kW):

    4 to 8 hours on site, 3 days for report. See

    how to plan rooftop solar for homes

    .

  • C&I rooftop (50 kW to 1 MW):

    1 to 2 days on site, 5 to 7 days for report. See

    solar for factories

    .

  • Ground-mount (1 MW plus):

    3 to 5 days on site, 10 to 14 days for report.

Free or Paid? Industry Norms

  • Free survey:

    Standard for projects above 50 kW, refunded against advance.

  • Paid survey:

    ₹15,000 to ₹1.5 lakhs for large ground-mount, adjustable in contract value.

  • Red flag:

    Any EPC that quotes pricing

    without

    a site visit. Detailed warning signs are in our

    solar EPC red flags

    guide.

For financing structures, compare CAPEX vs RESCO solar financing.

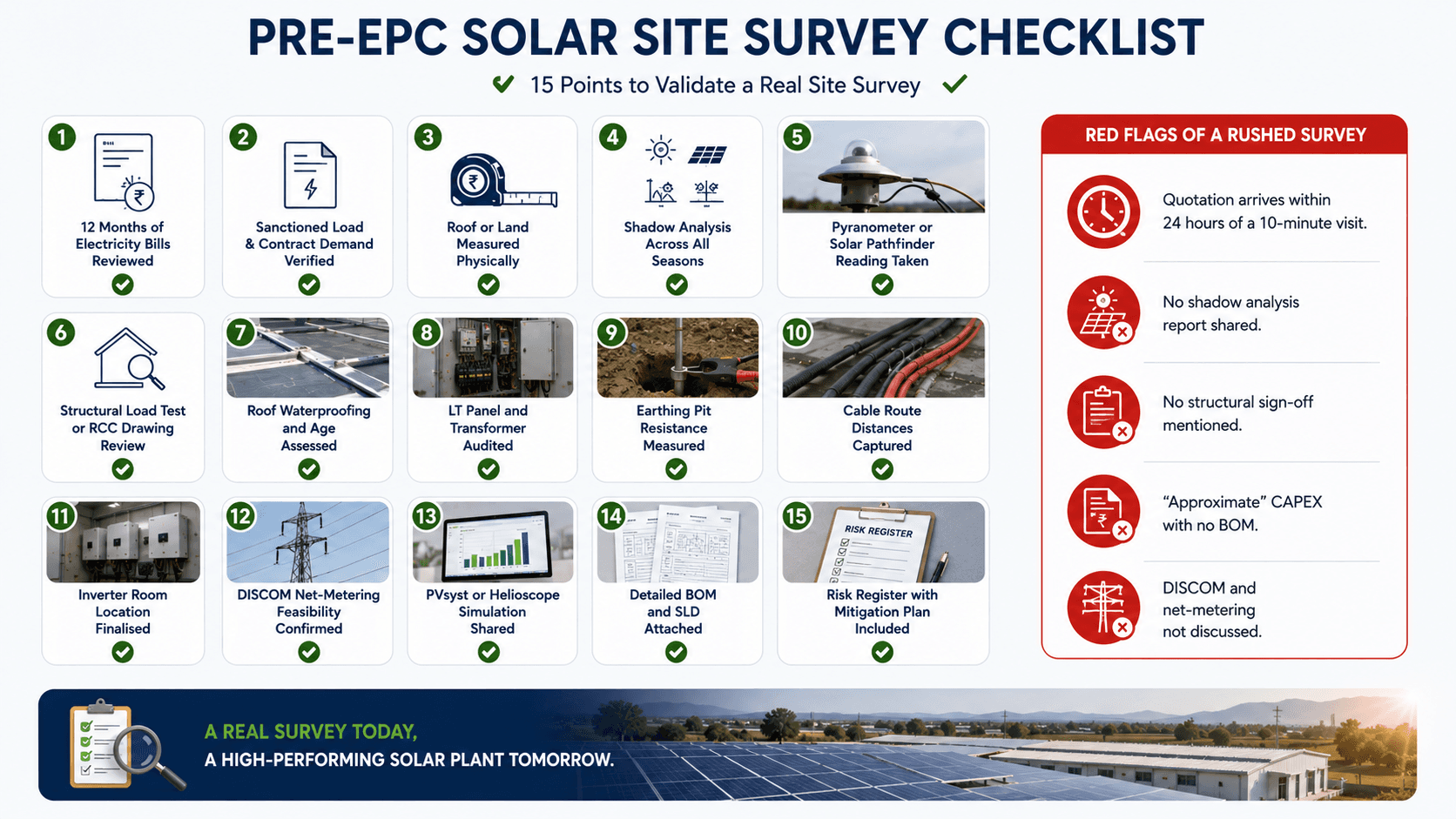

Pre-EPC Solar Site Survey Checklist

image - 2026-07-02T211049.921

Use this 15-point checklist to validate whether your EPC ran a real survey or a desktop exercise. Combine it with our broader solar EPC company checklist for India.

  1. 12 months of electricity bills reviewed

  2. Sanctioned load and contract demand verified

  3. Roof or land measured physically

  4. Shadow analysis across all seasons

  5. Pyranometer or solar pathfinder reading taken

  6. Structural load test or RCC drawing review

  7. Roof waterproofing and age assessed

  8. LT panel and transformer audited

  9. Earthing pit resistance measured

  10. Cable route distances captured

  11. Inverter room location finalised

  12. DISCOM net-metering feasibility confirmed

  13. PVsyst or Helioscope simulation shared

  14. Detailed BOM and SLD attached

  15. Risk register with mitigation plan included

Red Flags of a Rushed Survey

  • Quotation arrives within 24 hours of a 10-minute visit.

  • No shadow analysis report shared.

  • No structural sign-off mentioned.

  • "Approximate" CAPEX with no BOM.

  • DISCOM and net-metering not discussed.


Questions to Ask Your EPC Contractor

Use these questions to separate a real EPC from a reseller before and after the survey.

Before the Survey

  • Who from your team will visit and what are their qualifications?

  • Which software do you use for shadow and generation analysis?

  • Will the survey include a structural sign-off?

  • Do you check

    DISCOM and net-metering feasibility

    on site?

After the Survey

  • What is the Performance Ratio you have modelled?

  • What are the top 3 risks in my site and how will you mitigate them?

  • Can I see the BOM, SLD, and DPR before payment?

  • What generation guarantee will you back contractually?


Common Mistakes Clients Make During the Pre-EPC Survey Phase

Most CAPEX surprises come from the client side, not the EPC side. Avoid these 3 mistakes.

  • Hiding load data:

    Sharing partial bills leads to under-sized systems.

  • Skipping facility team involvement:

    Maintenance teams know the roof leaks, beams, and downtime windows. They are also key to long-term

    solar plant maintenance

    .

  • Accepting verbal estimates:

    If it is not in a signed DPR, it does not exist.


How a Thorough Site Survey Translates Into Better Generation, Lower CAPEX, and Faster ROI

A serious solar site survey is the single highest-ROI activity in the entire EPC lifecycle. It directly moves three numbers that decide the project's success.

  • Generation:

    5% to 12% higher annual yield through precise tilt, azimuth, and shading.

  • CAPEX:

    8% to 15% lower because cable runs, structures, and BOM are right-sized. Benchmark against

    solar energy savings in India

    .

  • Payback:

    Compresses by 6 to 12 months on a typical 500 kW plant. See

    solar payback period India 2026

    .

This is why a strong EPC partner treats the survey as engineering, not sales.


About Earthwave Solar: A Pre-EPC Survey-First EPC Partner

image - 2026-07-02T211054.313

Earthwave Solar is a complete EPC solutions company that built its reputation by running engineering-grade site surveys before quoting a single rupee.

Company Snapshot

  • Established:

    2018, with offices in Surat (Gujarat) and Bhopal (Madhya Pradesh).

  • Track record:

    First 100 kW installation in 2019, 80 MW ground-mount executed for Mahindra Susten in 2021. Browse our full

    project portfolio

    .

  • Vertical integration:

    In-house

    Wave inverter manufacturing

    since 2024, solar module manufacturing and multi-state expansion in 2025.

Services Offered

Why Earthwave's Pre-EPC Survey Is Different

  • Site Visit and Consulting is a dedicated Step 2 in the Earthwave process, not a sales call.

  • Structural, electrical, and design engineers visit together.

  • Every quotation is backed by a written DPR, BOM, and SLD.

  • DISCOM and subsidy paperwork are handled in Step 4, after the survey locks the design.

  • Trusted by Goldi Solar, Mahindra Susten, Torrent Power, GUVNL, Solnce, Deon Energy, True Colors, and Rajesh Power Services.


FAQ: Pre-EPC Solar Site Survey

1. How accurate is a solar site survey?

A professionally conducted site survey is 90% to 95% accurate in predicting annual generation. The remaining variance comes from weather and grid uptime, both outside the EPC's control.

2. Can a solar site survey be done remotely?

Remote-only surveys work for preliminary feasibility up to 10 kW. For anything above 50 kW, a physical visit is mandatory because structural and electrical risks cannot be verified on satellite images.

3. Do I have to pay for the site survey if I do not sign the EPC contract?

For projects below 500 kW, most EPCs including Earthwave Solar offer the survey free. For large ground-mount plants, a refundable engineering fee of ₹15,000 to ₹1.5 lakhs is standard.

4. What happens if the survey reveals the roof is not suitable?

The EPC proposes alternatives such as elevated structures, ground-mount on adjacent land, or a phased rollout. See rooftop vs ground-mounted solar for industrial sites for that decision tree.

5. How is a site survey different from a feasibility study?

A feasibility study is a quick desktop check to confirm if solar makes sense. A site survey is the on-ground engineering audit that locks the design, BOM, generation, and CAPEX before the contract is signed.


Ready to Run a Real Pre-EPC Solar Site Survey?

If you are evaluating a rooftop, ground-mount, or carport solar project above 50 kW, the next right step is a proper engineering audit, not another sales quotation.

Book a free pre-EPC site survey with Earthwave Solar at www.earthwavetech.in or visit our contact page. For more guides, explore the full Earthwave Solar blog library.

You walk away with a written DPR, generation estimate, BOM, and CAPEX, even if you decide not to sign. That is what a survey-first EPC partner looks like.


FAQS

Your Questions Answered

Still Have A Question?

Can't find the answer you're looking for? Our team is here to help.

SUBSCRIBE NEWSLETTER

Stay Tuned with latest Updates

Switching to solar is easier than you think. Let us guide you to cleaner, more affordable energy.

EARTHWAVE
